Skip to main content

Batched EVM Transactions Using Cadence

Integrating Cadence into EVM applications on Flow enables developers to leverage the best of both worlds. This guide demonstrates how to batch EVM transactions using Cadence, allowing applications to embed multiple EVM transactions in a single Cadence transaction while conditioning final execution on the success of all EVM transactions.

This feature can supercharge your EVM application by unlocking experiences otherwise impossible on traditional EVM platforms.

Objectives​

After completing this guide, you'll be able to

  • Construct a Cadence transaction that executes several EVM transactions such that if any EVM transaction fails, the entire set will revert
  • Read and write from smart contract functions on EVM Flowscan
  • Run a Cadence transaction from the browser using Flow Runner
  • Install conceptual understanding of Cadence X EVM interactions
  • Inspect multiple EVM transactions embedded in a Cadence transaction with Flowscan block explorer
  • Write code that interacts with the EVM via a CadenceOwnedAccount (COA)

Prerequisites​

Before you dive in, make sure you have the following configured:

  • MetaMask installed in your browser with an active account
  • Flow Wallet extension installed in your browser with an active account
  • Both wallets funded with Testnet FLOW. See the Faucet guide for more information.

Overview​

For the purposes of demonstration, this walkthrough will focus on relatively simple EVM operations in addition to first creating a Cadence-controlled EVM account (COA). Specifically, we will:

  • Wrap FLOW as WFLOW
  • Approve an ERC721 to transfer WFLOW in exchange for an NFT mint
  • Mint an ERC721 token - this ERC721 has a 50% chance of failing (using onchain VRF to determine success)

These operations let us focus on the core concepts of this guide:

  1. Batching EVM transactions using Cadence
  2. Conditioning execution on the results of those EVM transactions.

However, using these same principles, you'll have the power to address more complex use cases. For instance, replace wrapping FLOW with a DEX swap. Or instead of minting an ERC721, purchase an NFT listing from a marketplace. Combine these two and suddenly you can purchase NFTs with any ERC20 token, all in a single Cadence transaction, reverting everything if a single step fails.

The point is, while a simple use case, this guide will give you the tools to build much more complex and interesting applications. So let's get started!

Components​

As mentioned in the Overview, this guide involves three main actions:

  • Wrapping FLOW as WFLOW
  • Approving an ERC721 to transfer WFLOW in exchange for an NFT mint
  • Minting an ERC721 token

Before interacting with these contracts, let's dig bit more into the components of this guide.

Wrap FLOW as WFLOW​

On Flow EVM, FLOW is the native currency and similar to other EVM platforms, the native currency is not accessible as an ERC20 token. To interact with ERC20 contracts, you need to wrap FLOW as WFLOW (Wrapped FLOW). This is Flow's equivalent of WETH on Ethereum.

tip

You can find WFLOW deployed to 0xd3bF53DAC106A0290B0483EcBC89d40FcC961f3e on Flow Testnet & Mainnet and source code in the @onflow/flow-sol-utils repository.

Approve ERC721 Transfer​

Our example MaybeMintERC721 contract accepts WFLOW in exchange for minting an NFT. However, the contract cannot move WFLOW without your permission. To allow the contract to move your WFLOW, you must approve the contract to transfer enough of your WFLOW to mint the NFT.

Mint ERC721 Token​

Finally, we'll mint an ERC721 token using the MaybeMintERC721 contract. This contract has a 50% chance of failing, simulating a real-world scenario where purchasing an NFT might fail - say a listing was purchased before your transaction was processed.

Importantly, if this transaction fails, we want to revert the entire sequence of transactions. After all, you wrapped FLOW to WFLOW and approved the ERC721 transfer specifically to mint this NFT. If the mint fails, you want to unwind everything. As we'll see shortly, this is where batching EVM transactions using Cadence is extremely powerful.

Interacting with the Contracts​

Before taking the easy route, let's first interact with the contracts individually to better understand the process and status quo user experience. Realistically, this is your only option for completing the whole process on other EVM platforms.

tip

Recall in Prerequisites that you need to have both MetaMask and Flow Wallet extension installed and funded with Testnet FLOW. Make sure you've done so before proceeding.

Using MetaMask​

1. Wrap FLOW​

Our first action will be to wrap enough FLOW to cover the cost of minting the MaybeMintERC721 token. To do this, we'll interact with the WFLOW contract on Testnet. There are a number of ways we could interact with this contract - Remix IDE, Foundry's CLI, Hardhat, etc. - but for the purposes of this guide, we'll use the Flowscan EVM block explorer.

Navigate to the WFLOW Testnet contract on Flowscan: WFLOW. Ensure you're on the Write Contract tab which allows you to interact with the contract's mutating functions.

Before you can interact with the contract, you need to connect your MetaMask wallet to the Flowscan EVM block explorer. Click the Connect button in the top right corner and follow the prompts to connect your MetaMask wallet.

warning

There are two separate block explorers for Flow - one for Cadence activity and another for EVM activity. This is unique to Flow and is due to the fact that Cadence & EVM are separate runtimes, with EVM effectively emulated within Cadence. This orientation - that of EVM running within Cadence - means that the Cadence-side explorer has visibility to EVM transactions embedded within a Cadence transaction.

Practically, this means that any transactions ran using a Flow native account can be viewed on the Cadence explorer while any transactions run using an EVM account can be viewed on the EVM explorer.

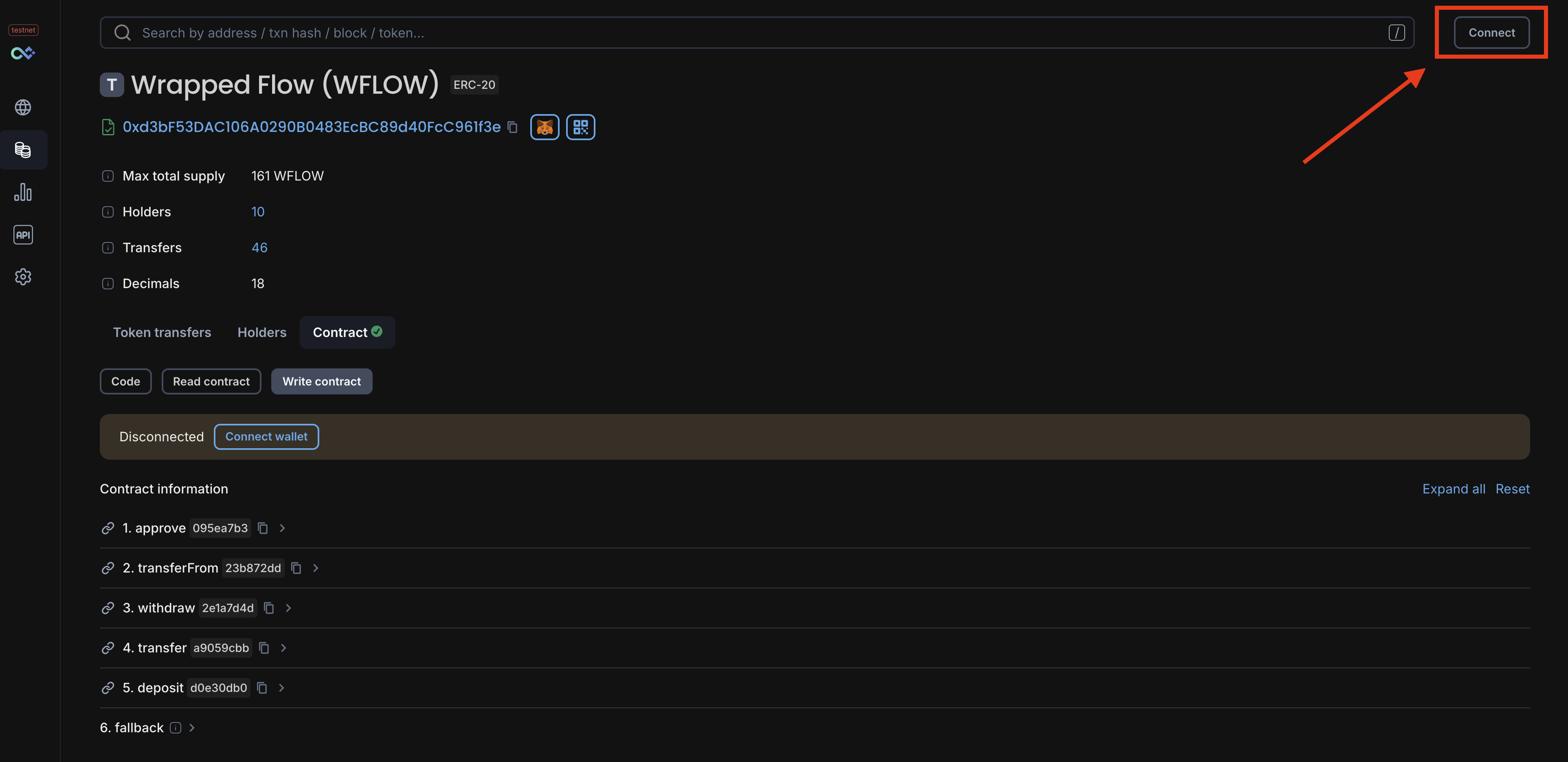

Connect wallet to Flowscan

Once connected, you should see your address in the top right corner and above the contract's functions.

Now we can wrap FLOW. Click on the deposit method which will drop down an input field for the amount of FLOW you want to wrap. The mint amount for the MaybeMintERC721 contract is 1 whole FLOW which in EVM terms is 1e18 wei - wei being the smallest unit of an EVM's native currency (inherited from Ethereum's units - more on Ether units here).

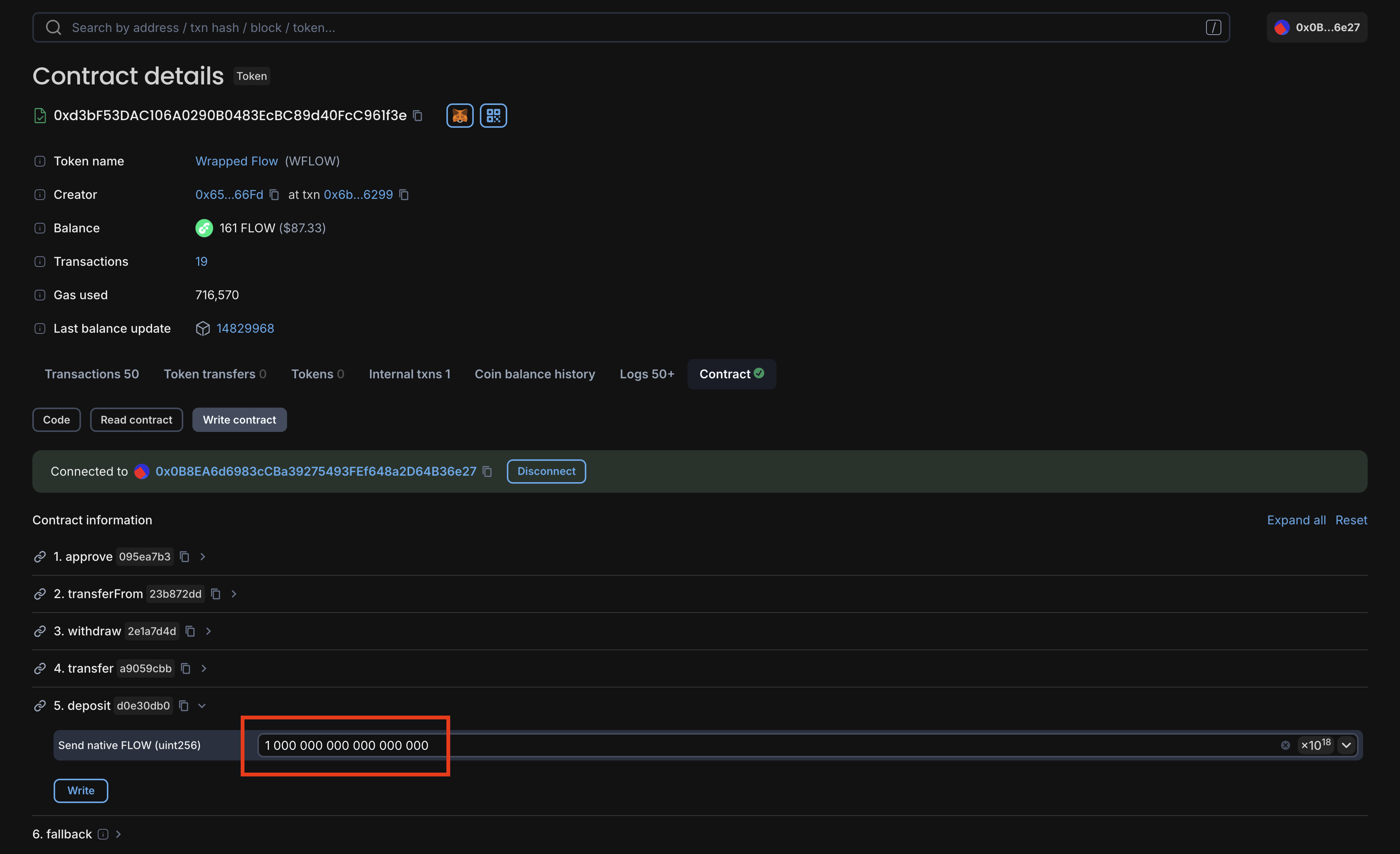

As shown below, put 1 000 000 000 000 000 000 in the input field for deposit.

Deposit 1 FLOW to WFLOW contract

You can now click the Write button to submit the transaction. Once MetaMask prompts you to sign the transaction, click Confirm and give it a few seconds to process.

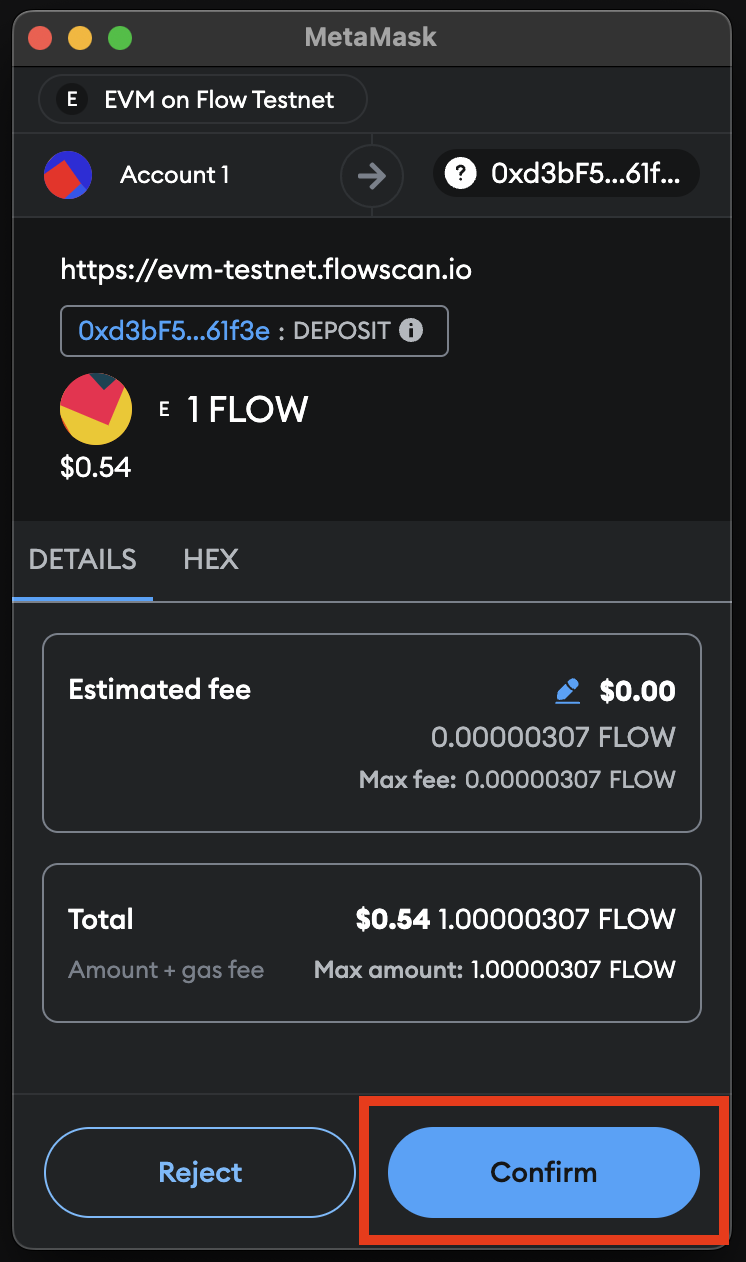

Confirm WFLOW deposit in MetaMask

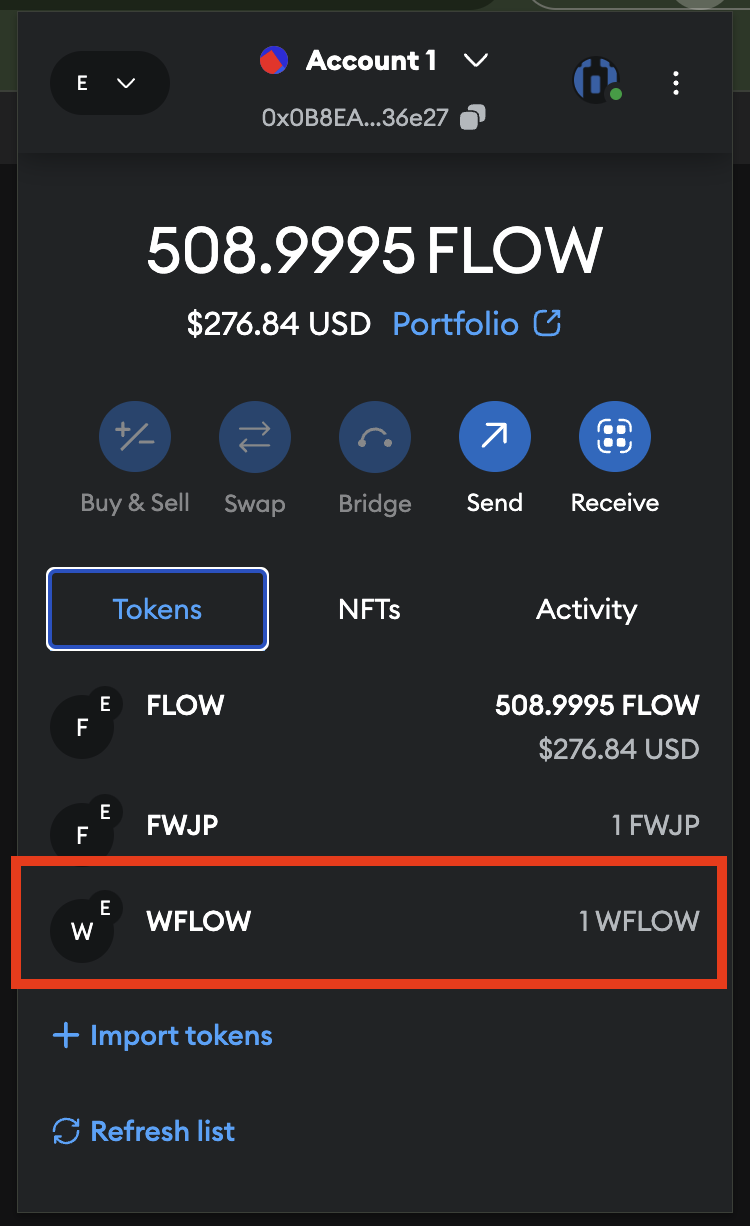

Once confirmed, you should be able to see WFLOW balance in your tokens list in MetaMask - if not, you can click on Import Tokens and paste the WFLOW contract address found on the Flowscan page and refresh your list.

WFLOW in MetaMask

2. Approve WFLOW Transfer​

Now that you have your WFLOW, you'll need to approve the MaybeMintERC721 contract to transfer your WFLOW. From the same WFLOW page in Flowscan, click on the approve method. This time, you'll need to input the MaybeMintERC721 contract address - 0x2E2Ed0Cfd3AD2f1d34481277b3204d807Ca2F8c2 - and the amount of WFLOW you want to approve - again 1 000 000 000 000 000 000 WFLOW.

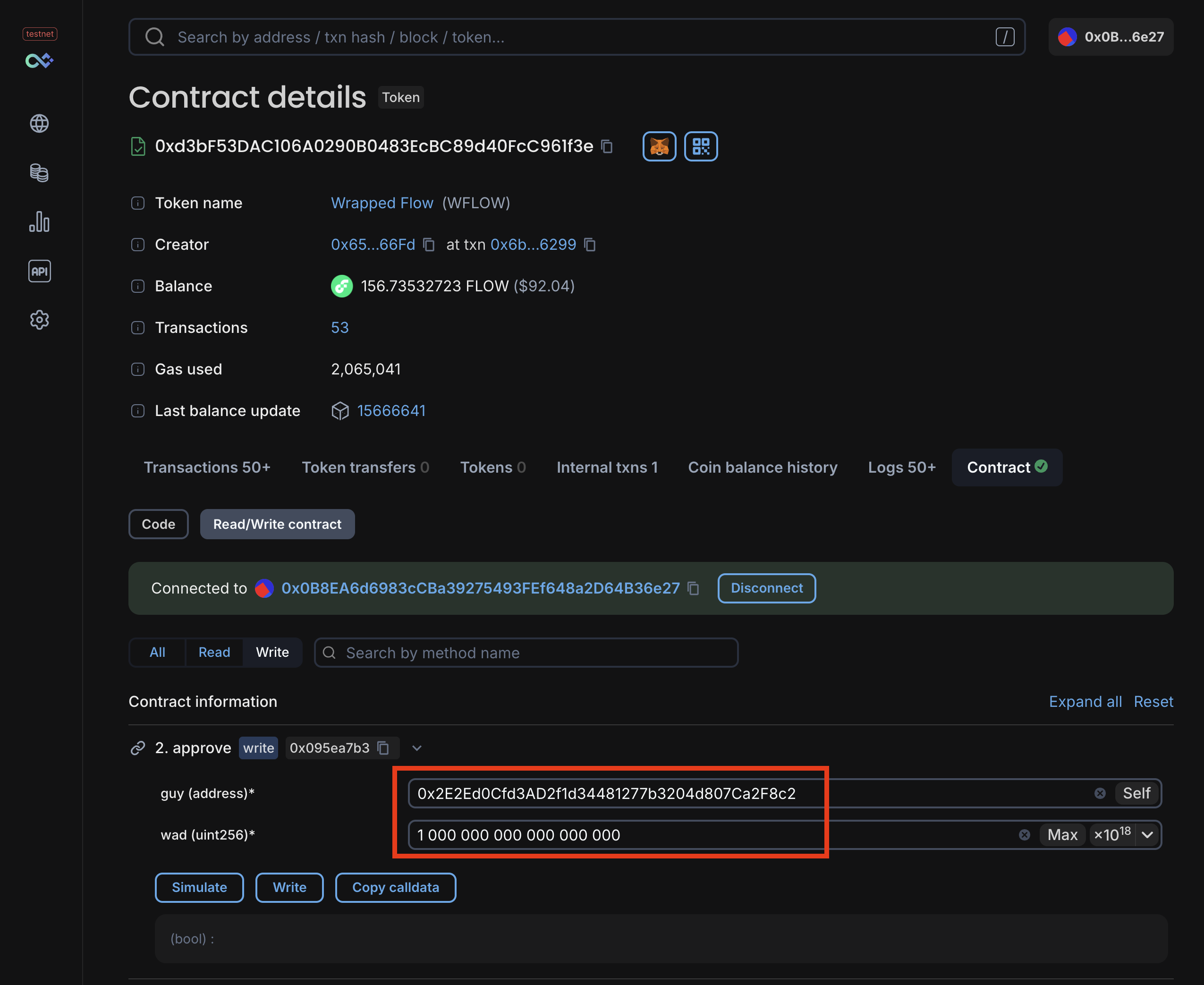

Approve MaybeMintERC721 for 1 WFLOW in Flowscan

Click Write to submit the transaction. To be clear, this does not complete a transfer, but allows the MaybeMintERC721 contract to transfer your WFLOW on your behalf which will execute in the next step.

3. Mint ERC721 Token​

Finally, we'll attempt to mint the ERC721 token using the MaybeMintERC721 contract. Navigate to the MaybeMintERC721 contract on Flowscan: MaybeMintERC721.

Again, you'll be met with the contract functions on the Write Contract tab. Click on the mint function which takes no arguments - just click on Write and then Confirm in the resulting MetaMask window.

This contract has a 50% chance of failing on mint using onchain randomness. If it fails, simply mint again until it succeeds.

On success, you can click on your NFTs in MetaMask to see your newly minted token.

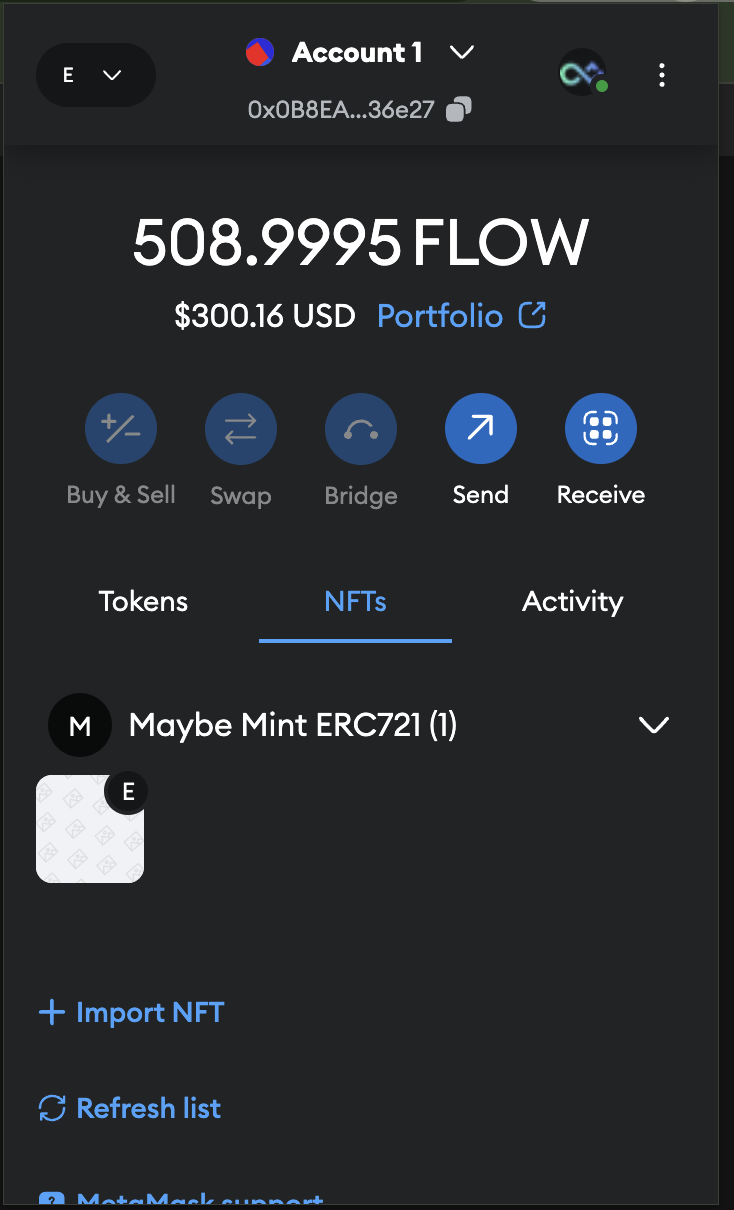

MaybeMintERC721 in MetaMask NFT list

Recap​

This process is cumbersome and requires multiple transactions, each of which could fail. Given the intent of the process - minting an NFT - if this were a case where the NFT was a limited edition or time-sensitive, you'd be left with WFLOW wrapped and approved for transfer, but no NFT and would need to manually unwind the process.

Or you could just use Cadence to batch these transactions and revert everything if the mint fails. Let's do that.

Using Flow Wallet​

Before diving into the "how", let's execute the batched version of everything we just did using Flow Wallet. This will give you a sense of the power of Cadence and the Flow blockchain.

The transaction below, like all Cadence transactions, is scripted, allowing us to execute a series of actions. It may look like a lot at first, but we will break it down step by step in the following sections.

wrap_and_mint.cdc

_140
// TESTNET IMPORTS
_140
import FungibleToken from 0x9a0766d93b6608b7
_140
import FlowToken from 0x7e60df042a9c0868
_140
import EVM from 0x8c5303eaa26202d6
_140
_140
/// This transaction demonstrates how multiple EVM calls can be batched in a single Cadence transaction via
_140
/// CadenceOwnedAccount (COA), performing the following actions:
_140
///
_140
/// 1. Configures a COA in the signer's account if needed
_140
/// 2. Funds the signer's COA with enough FLOW to cover the WFLOW cost of minting an ERC721 token
_140
/// 3. Wraps FLOW as WFLOW - EVM call 1
_140
/// 4. Approves the example MaybeMintERC721 contract which accepts WFLOW to move the mint amount - EVM call 2
_140
/// 5. Attempts to mint an ERC721 token - EVM call 3
_140
///
_140
/// Importantly, the transaction is reverted if any of the EVM interactions fail returning the account to the original
_140
/// state before the transaction was executed across Cadence & EVM.
_140
///
_140
/// For more context, see https://github.com/onflow/batched-evm-exec-example
_140
///
_140
/// @param wflowAddressHex: The EVM address hex of the WFLOW contract as a String
_140
/// @param maybeMintERC721AddressHex: The EVM address hex of the ERC721 contract as a String
_140
///
_140
transaction(wflowAddressHex: String, maybeMintERC721AddressHex: String) {
_140
_140
let coa: auth(EVM.Call) &EVM.CadenceOwnedAccount
_140
let mintCost: UFix64
_140
let wflowAddress: EVM.EVMAddress
_140
let erc721Address: EVM.EVMAddress
_140
_140
prepare(signer: auth(SaveValue, BorrowValue, IssueStorageCapabilityController, PublishCapability, UnpublishCapability) &Account) {
_140
/* COA configuration & assigment */
_140
//
_140
let storagePath = /storage/evm
_140
let publicPath = /public/evm
_140
// Configure a COA if one is not found in storage at the default path
_140
if signer.storage.type(at: storagePath) == nil {
_140
// Create & save the CadenceOwnedAccount (COA) Resource
_140
let newCOA <- EVM.createCadenceOwnedAccount()
_140
signer.storage.save(<-newCOA, to: storagePath)
_140
_140
// Unpublish any existing Capability at the public path if it exists
_140
signer.capabilities.unpublish(publicPath)
_140
// Issue & publish the public, unentitled COA Capability
_140
let coaCapability = signer.capabilities.storage.issue<&EVM.CadenceOwnedAccount>(storagePath)
_140
signer.capabilities.publish(coaCapability, at: publicPath)
_140
}
_140
_140
// Assign the COA reference to the transaction's coa field
_140
self.coa = signer.storage.borrow<auth(EVM.Call) &EVM.CadenceOwnedAccount>(from: storagePath)
_140
?? panic("A CadenceOwnedAccount (COA) Resource could not be found at path ".concat(storagePath.toString())
_140
.concat(" - ensure the COA Resource is created and saved at this path to enable EVM interactions"))
_140
_140
/* Fund COA with cost of mint */
_140
//
_140
// Borrow authorized reference to signer's FlowToken Vault
_140
let sourceVault = signer.storage.borrow<auth(FungibleToken.Withdraw) &FlowToken.Vault>(
_140
from: /storage/flowTokenVault
_140
) ?? panic("The signer does not store a FlowToken Vault object at the path "
_140
.concat("/storage/flowTokenVault. ")
_140
.concat("The signer must initialize their account with this vault first!"))
_140
// Withdraw from the signer's FlowToken Vault
_140
self.mintCost = 1.0
_140
let fundingVault <- sourceVault.withdraw(amount: self.mintCost) as! @FlowToken.Vault
_140
// Deposit the mint cost into the COA
_140
self.coa.deposit(from: <-fundingVault)
_140
_140
/* Set the WFLOW contract address */
_140
//
_140
// View the cannonical WFLOW contract at:
_140
// https://evm-testnet.flowscan.io/address/0xd3bF53DAC106A0290B0483EcBC89d40FcC961f3e
_140
self.wflowAddress = EVM.addressFromString(wflowAddressHex)
_140
_140
/* Assign the ERC721 EVM Address */
_140
//
_140
// Deserialize the provided ERC721 hex string to an EVM address
_140
self.erc721Address = EVM.addressFromString(maybeMintERC721AddressHex)
_140
}
_140
_140
pre {
_140
self.coa.balance().inFLOW() >= self.mintCost:
_140
"CadenceOwnedAccount holds insufficient FLOW balance to mint - "
_140
.concat("Ensure COA has at least ".concat(self.mintCost.toString()).concat(" FLOW"))
_140
}
_140
_140
execute {
_140
/* Wrap FLOW in EVM as WFLOW */
_140
//
_140
// Encode calldata & set value
_140
let depositCalldata = EVM.encodeABIWithSignature("deposit()", [])
_140
let value = EVM.Balance(attoflow: 0)
_140
value.setFLOW(flow: self.mintCost)
_140
// Call the WFLOW contract, wrapping the sent FLOW
_140
let wrapResult = self.coa.call(
_140
to: self.wflowAddress,
_140
data: depositCalldata,
_140
gasLimit: 15_000_000,
_140
value: value
_140
)
_140
assert(
_140
wrapResult.status == EVM.Status.successful,
_140
message: "Wrapping FLOW as WFLOW failed: ".concat(wrapResult.errorMessage)
_140
)
_140
_140
/* Approve the ERC721 address for the mint amount */
_140
//
_140
// Encode calldata approve(address,uint) calldata, providing the ERC721 address & mint amount
_140
let approveCalldata = EVM.encodeABIWithSignature(
_140
"approve(address,uint256)",
_140
[self.erc721Address, UInt256(1_000_000_000_000_000_000)]
_140
)
_140
// Call the WFLOW contract, approving the ERC721 address to move the mint amount
_140
let approveResult = self.coa.call(
_140
to: self.wflowAddress,
_140
data: approveCalldata,
_140
gasLimit: 15_000_000,
_140
value: EVM.Balance(attoflow: 0)
_140
)
_140
assert(
_140
approveResult.status == EVM.Status.successful,
_140
message: "Approving ERC721 address on WFLOW contract failed: ".concat(approveResult.errorMessage)
_140
)
_140
_140
/* Attempt to mint ERC721 */
_140
//
_140
// Encode the mint() calldata
_140
let mintCalldata = EVM.encodeABIWithSignature("mint()", [])
_140
// Call the ERC721 contract, attempting to mint
_140
let mintResult = self.coa.call(
_140
to: self.erc721Address,
_140
data: mintCalldata,
_140
gasLimit: 15_000_000,
_140
value: EVM.Balance(attoflow: 0)
_140
)
_140
// If mint fails, all other actions in this transaction are reverted
_140
assert(
_140
mintResult.status == EVM.Status.successful,
_140
message: "Minting ERC721 token failed: ".concat(mintResult.errorMessage)
_140
)
_140
}
_140
}

You can run the transaction at the following link using the community-developed Flow Runner tool: wrap_and_mint.cdc.

This transaction takes two arguments:

  • WFLOW contract address: 0xd3bF53DAC106A0290B0483EcBC89d40FcC961f3e
  • MaybeMintERC721 contract address: 0x2E2Ed0Cfd3AD2f1d34481277b3204d807Ca2F8c2

Before running, ensure that the network section - bottom right corner - displays Testnet. If not, click and select Testnet as your network and refresh. Once you've confirmed you're Flow Runner is targeting Testnet, copy these addresses and paste them into the respective fields on the Flow Runner page. Click Run on the top left and follow the prompts to connect your Flow Wallet and sign the transaction.

warning

Although we are running a manual transaction for the purposes of this walkthrough, you should always be careful to review the transaction details before signing and submitting.

Again, since the ERC721 has a 50% chance of failing, you may need to run the transaction multiple times until it succeeds. However note that if the mint fails, the entire transaction will revert, unwinding the wrapped FLOW and approval.

Again, since the ERC721 has a 50% chance of failure and the success of the transaction is conditioned on successfully minting, your transaction may fail. If it does fail, importantly the entire transaction reverts, unwinding the wrapped FLOW deposit and approval - the wrapping and approval transactions do not execute in the event of mint failure! This is the main takeaway of this guide, that you embed a whole sequence of EVM transactions into one atomic operation using Cadence and if the primary intent (or intents) does not execute, everything else is reverted as well.

In our case, you'll want to submit a transaction until one succeeds. Once you submit a successful transaction, you'll see a transaction ID with event logs in the Flow Runner output. Let's take a closer look at the transaction and its results in the Flowscan block explorer.

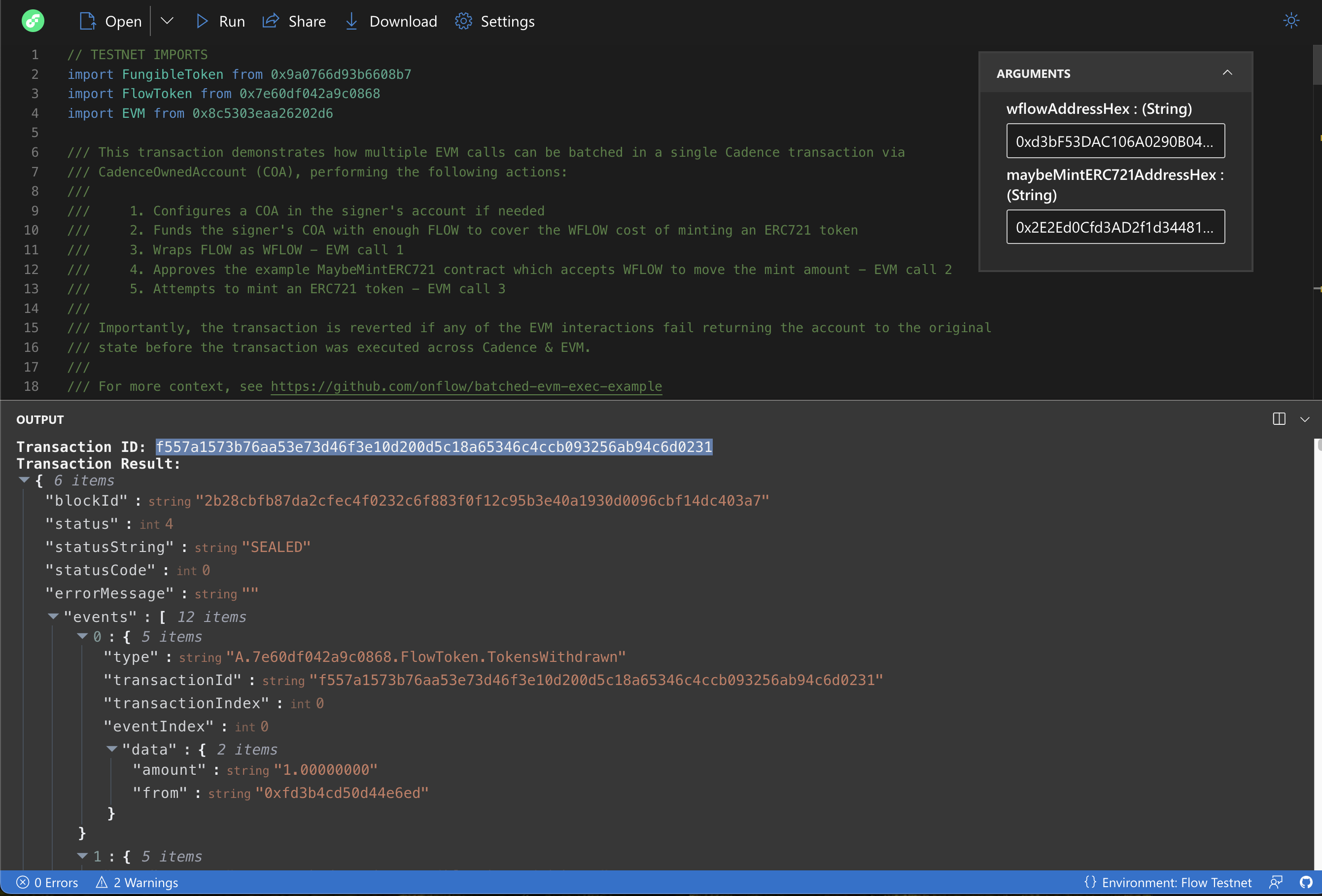

Flow Runner output on successful transaction execution

Copy your transaction ID and go to the Flowscan Testnet Cadence block explorer: Flowscan Cadence.

Pasting your transaction ID into the search bar will show you the transaction details, including the Cadence script, execution status, and event logs. Click on the EVM tab to view the EVM transactions batched in the Cadence transaction.

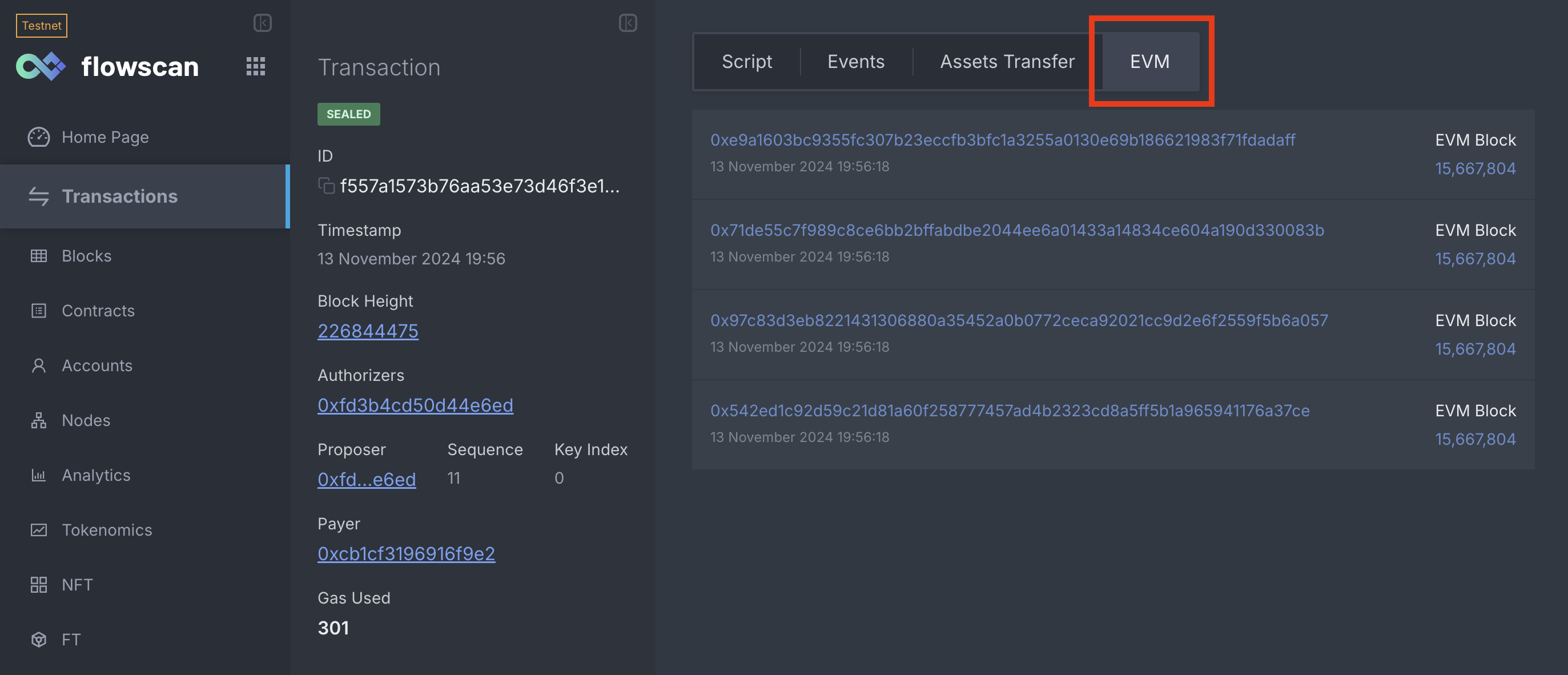

Embedded EVM transactions on Flowscan

Clicking on the transactions will open up the EVM transaction in Flowscan's EVM block explorer. If you view the EVM transactions in order, you'll notice that they aggregate the same actions we took manually in the MetaMask section, but this time in a single Cadence transaction!

Breaking it Down​

Now that we can relate to the pain of manually executing these transactions and we've seen the magic you can work with Cadence, let's understand what's going on under the hood.

To recap, our Cadence transaction does the following, reverting if any step fails:

  1. Wraps FLOW as WFLOW
  2. Approves the MaybeMintERC721 contract to move WFLOW
  3. Attempts to mint a MaybeMintERC721 token

But how does our Flow account interact with EVM from the Cadence runtime? As you'll recall from the Interacting with COA guide, we use a Cadence-owned account (COA) to interact with EVM contracts from Cadence.

A COA is a resource providing an interface through which Cadence can interact with the EVM runtime. This is importantly in addition to the traditional routes you'd normally access normal EVMs - e.g. via the JSON-RPC API. And with this interface, we can take advantage of all of the benefits of Cadence - namely here scripted transactions and conditional execution.

So in addition to the above steps, our transaction first configures a COA in the signer's account if one doesn't already exist. It then funds the COA with enough FLOW to cover the mint cost, sourcing funds from the signing Flow account's Cadence Vault. Finally, it wraps FLOW as WFLOW, approves the ERC721 contract to move the mint amount, and attempts to mint the ERC721 token.

Let's see what each step looks like in the transaction code.

COA Configuration​

The first step in our transaction is to configure a COA in the signer's account if one doesn't already exist. This is done by creating a new COA resource and saving it to the signer account's storage. A public Capability on the COA is then issued and published on the signer's account, allowing anyone to deposit FLOW into the COA, affecting its EVM balance.


_21
/* COA configuration & assignment */
_21
//
_21
let storagePath = /storage/evm
_21
let publicPath = /public/evm
_21
// Configure a COA if one is not found in storage at the default path
_21
if signer.storage.type(at: storagePath) == nil {
_21
// Create & save the CadenceOwnedAccount (COA) Resource
_21
let newCOA <- EVM.createCadenceOwnedAccount()
_21
signer.storage.save(<-newCOA, to: storagePath)
_21
_21
// Unpublish any existing Capability at the public path if it exists
_21
signer.capabilities.unpublish(publicPath)
_21
// Issue & publish the public, unentitled COA Capability
_21
let coaCapability = signer.capabilities.storage.issue<&EVM.CadenceOwnedAccount>(storagePath)
_21
signer.capabilities.publish(coaCapability, at: publicPath)
_21
}
_21
_21
// Assign the COA reference to the transaction's coa field
_21
self.coa = signer.storage.borrow<auth(EVM.Call) &EVM.CadenceOwnedAccount>(from: storagePath)
_21
?? panic("A CadenceOwnedAccount (COA) Resource could not be found at path ".concat(storagePath.toString())
_21
.concat(" - ensure the COA Resource is created and saved at this path to enable EVM interactions"))

At the end of this section, the transaction now has an reference authorized with the EVM.Call entitlement to use in the execute block which can be used call into EVM.

You can run a transaction that does just this step here: setup_coa.cdc

Since you ran the all-in-one transaction previously, your account already has a COA configured in which case the linked transaction won't do anything. You can lookup your Testnet account's EVM address with the script below to confirm you have a COA configured. Simply input your Testnet Flow address and click Run.

Funding the COA​

Next, we fund the COA with enough FLOW to cover the mint cost. This is done by withdrawing FLOW from the signer's FlowToken Vault and depositing it into the COA.


_13
/* Fund COA with cost of mint */
_13
//
_13
// Borrow authorized reference to signer's FlowToken Vault
_13
let sourceVault = signer.storage.borrow<auth(FungibleToken.Withdraw) &FlowToken.Vault>(
_13
from: /storage/flowTokenVault
_13
) ?? panic("The signer does not store a FlowToken Vault object at the path "
_13
.concat("/storage/flowTokenVault. ")
_13
.concat("The signer must initialize their account with this vault first!"))
_13
// Withdraw from the signer's FlowToken Vault
_13
self.mintCost = 1.0
_13
let fundingVault <- sourceVault.withdraw(amount: self.mintCost) as! @FlowToken.Vault
_13
// Deposit the mint cost into the COA
_13
self.coa.deposit(from: <-fundingVault)

Taking a look at the full transaction, we can see an explicit check that the COA has enough FLOW to cover the mint cost before proceeding into the transaction's execute block.


_10
pre {
_10
self.coa.balance().inFLOW() >= self.mintCost:
_10
"CadenceOwnedAccount holds insufficient FLOW balance to mint - "
_10
.concat("Ensure COA has at least ".concat(self.mintCost.toString()).concat(" FLOW"))
_10
}

This isn't absolutely necessary as successive steps would fail on this condition, but helps provide enhanced error messages in the event of insufficient funds.

You can run the above block in a transaction here which will move 1 FLOW from your account's Cadence FLOW balance to your account's EVM balance, depositing it directly to your pre-configured COA: fund_coa.cdc

After running the linked transaction, you can check your COA's FLOW balance with the script below, just enter your COA's EVM address (which you can get from the previous script). The resulting balance should be 1.0 (unless you've funded your COA prior to this walkthrough).

Setting our EVM Contract Targets​

The last step in our transaction's prepare block is to deserialize the provided WFLOW and ERC721 contract addresses from hex strings to EVM addresses.


_10
/* Set the WFLOW contract address */
_10
//
_10
// View the cannonical WFLOW contract at:
_10
// https://evm-testnet.flowscan.io/address/0xd3bF53DAC106A0290B0483EcBC89d40FcC961f3e
_10
self.wflowAddress = EVM.addressFromString(wflowAddressHex)
_10
_10
/* Assign the ERC721 EVM Address */
_10
//
_10
// Deserialize the provided ERC721 hex string to an EVM address
_10
self.erc721Address = EVM.addressFromString(maybeMintERC721AddressHex)

Wrapping FLOW as WFLOW​

Next, we're on to the first EVM interaction - wrapping FLOW as WFLOW. This is done by encoding the deposit() function call and setting the call value to the mint cost. The COA then calls the WFLOW contract with the encoded calldata, gas limit, and value.


_17
/* Wrap FLOW in EVM as WFLOW */
_17
//
_17
// Encode calldata & set value
_17
let depositCalldata = EVM.encodeABIWithSignature("deposit()", [])
_17
let value = EVM.Balance(attoflow: 0)
_17
value.setFLOW(flow: self.mintCost)
_17
// Call the WFLOW contract, wrapping the sent FLOW
_17
let wrapResult = self.coa.call(
_17
to: self.wflowAddress,
_17
data: depositCalldata,
_17
gasLimit: 15_000_000,
_17
value: value
_17
)
_17
assert(
_17
wrapResult.status == EVM.Status.successful,
_17
message: "Wrapping FLOW as WFLOW failed: ".concat(wrapResult.errorMessage)
_17
)

Setting the value of the call transmits FLOW along with the call to the contract, accessible in solidity as msg.value.

tip

You'll notice a general pattern among all EVM calls in this transaction:

  1. Encoding the calldata
  2. Calling the contract
  3. Asserting the call was successful

Here we're just interested in a successful call, but we could access return data if it were expected and relevant for our Cadence transaction. This returned data is accessible from the data field on the EVM.Result object returned from coa.call(...). This data would then be decoded using EVM.decodeABI(...). More on this in later guides.

You can run the above code as a transaction here: wrap_flow.cdc

After running the transaction, your COA should have a WFLOW balance of 1.0 WFLOW. Confirm your WFLOW balance by running the script below, providing your Flow account address, the WFLOW address of 0xd3bF53DAC106A0290B0483EcBC89d40FcC961f3e and your COA's EVM address (retrieved from a previous script):

Since Solidity does not support decimal precision, the returned balance will look like a large number. In the case of WFLOW, we can recover the decimals by shifting the decimal place 18 digits to the left. Your account should have 1 WFLOW or 1000000000000000000 as returned.

warning

Note that the number of places to shift varies by ERC20 implementation -- the default value is 18, but it's not safe to assume this value. You can check a token's decimal places by calling ERC20.decimals()(uint8).

Approving the ERC721 Contract​

Once the FLOW is wrapped as WFLOW, we approve the ERC721 contract to move the mint amount. This is done by encoding the approve(address,uint256) calldata and calling the WFLOW contract with the encoded calldata.


_18
/* Approve the ERC721 address for the mint amount */
_18
//
_18
// Encode calldata approve(address,uint) calldata, providing the ERC721 address & mint amount
_18
let approveCalldata = EVM.encodeABIWithSignature(
_18
"approve(address,uint256)",
_18
[self.erc721Address, UInt256(1_000_000_000_000_000_000)]
_18
)
_18
// Call the WFLOW contract, approving the ERC721 address to move the mint amount
_18
let approveResult = self.coa.call(
_18
to: self.wflowAddress,
_18
data: approveCalldata,
_18
gasLimit: 15_000_000,
_18
value: EVM.Balance(attoflow: 0)
_18
)
_18
assert(
_18
approveResult.status == EVM.Status.successful,
_18
message: "Approving ERC721 address on WFLOW contract failed: ".concat(approveResult.errorMessage)
_18
)

You can run this approval using the transaction, passing the WFLOW address of 0xd3bF53DAC106A0290B0483EcBC89d40FcC961f3e and MaybeMintERC721 address of 0x2E2Ed0Cfd3AD2f1d34481277b3204d807Ca2F8c2 : approve_maybe_mint_erc721.cdc

The linked transaction will perform the approval step, authorizing the ERC721 to transfer WFLOW to cover the mint cost when mint() is called. Confirm the contract allowance by running the script below. Pass your Flow address, WFLOW address, ERC721 address, and your COA's EVM address.

The result is the amount of your WFLOW balance the ERC721 is allowed to transfer, which after the transaction should be 1 WFLOW, or 1000000000000000000 as returned.

Minting the ERC721 Token​

Finally, we attempt to mint the ERC721 token. This is done by encoding the mint() calldata and calling the ERC721 contract with the encoded calldata. If the mint fails, the entire transaction is reverted.


_16
/* Attempt to mint ERC721 */
_16
//
_16
// Encode the mint() calldata
_16
let mintCalldata = EVM.encodeABIWithSignature("mint()", [])
_16
// Call the ERC721 contract, attempting to mint
_16
let mintResult = self.coa.call(
_16
to: self.erc721Address,
_16
data: mintCalldata,
_16
gasLimit: 15_000_000,
_16
value: EVM.Balance(attoflow: 0)
_16
)
_16
// If mint fails, all other actions in this transaction are reverted
_16
assert(
_16
mintResult.status == EVM.Status.successful,
_16
message: "Minting ERC721 token failed: ".concat(mintResult.errorMessage)
_16
)

You can run the minting transaction here, passing the ERC721 address of 0x2E2Ed0Cfd3AD2f1d34481277b3204d807Ca2F8c2: mint.cdc

Again, this transaction may fail. But if you executed all the prior stepwise transactions according to the walkthrough, you can try again until the mint succeeds. Recall that you can view your transaction details using Cadence Flowscan which will also let you view the embedded EVM transactions in the EVM tab. Try it out, and see if you can figure out how to get your minted NFT's URI with the script below.

Recap​

All of the stepwise transactions you just executed are compiled in the first Cadence transaction we ran. Hopefully, going through the process step by step illuminates the power and flexibility of Cadence, allowing you to write transactions as simple or as complex as you want.

While lengthy transactions can be intimidating and even a bit verbose at times, the flexibility afforded by the language means you are only limited by your imagination. Cadence transactions allow you to support the most streamlined of experiences, incorporating as many contracts as needed to support your use case.

Conclusion​

In this guide, we've demonstrated how to batch EVM transactions using Cadence, allowing you to conditionally execute multiple EVM transactions in a single Cadence transaction. While this guide focused on relatively simple EVM operations, the principles can be applied to much more complex and interesting applications.

In the process, you learned how to:

  • Read and write from smart contract functions on EVM Flowscan
  • Run a Cadence transaction from the browser using Flow Runner
  • Execute batched EVM transactions via a COA in a Cadence transaction
  • Condition final transaction execution on success of all EVM transactions
  • Inspect multiple EVM transactions embedded in a Cadence transaction with Flowscan block explorer

The biggest takeaway here isn't the specific actions taken in this walkthrough, but the overarching concept that you can use Cadence as an orchestration layer to extend existing EVM contracts, creating unique user experiences with the power to differentiate your Web3 application.

With these basics in hand, you're ready to start building more complex applications that leverage the power of Cadence and the Flow blockchain. How will you use these features to build Web3's next killer app?

Further Reading​

Now that you've experienced the power of Cadence and EVM interactions firsthand, we recommend checking out the following guides to deepen your understanding:

Ready to level up your Cadence skills? Take a look at these Cadence tutorials.
